SADAT Knowledge & Intelligence Consultation
GIR-001 Ground Intelligence Report Free to read

NIMZ Zaheerabad

What happens after the factories and infrastructure?

A field investigation from Gachibowli to NIMZ Zaheerabad. The infrastructure is real and under construction. The jobs, the people and the housing demand that are supposed to follow it have not yet been shown to exist — and that gap is what this report is about.

Sadat HM beside the NICDIT Zaheerabad Industrial Smart City Phase-I area statement board, with a new internal road and street lighting behind
At the Phase-I project board. Field observation recorded during GIR-001.
Published
24 September 2026
Research period
Field visit 9 August 2026 · desk research to September 2026
Field visits
9 Aug 2026
Location
Nyalkal and Jharasangam mandals, Sangareddy district, Telangana
Last verified
24 September 2026
Next review
31 December 2026
Researcher
Sadat HM · TSRERA A02200001905
Status
CURRENT
Report
GIR-001 · first edition
Route
Gachibowli → Patancheru → Sangareddy → Sadashivpet → NIMZ Zaheerabad
Research type
Ground intelligence + desk research
Investigator
Sadat HM · TSRERA A02200001905
Field visit
9 August 2026 · video and photographs on file
Scope
Intelligence report — not a property recommendation or return forecast
01 · Executive summary

The infrastructure is real. The demand it is supposed to create has not yet been shown.

GIR-001 did not set out to find a property. It set out to understand what is actually happening on the ground between Hyderabad and Zaheerabad, and particularly around the National Investment and Manufacturing Zone (NIMZ) north of Zaheerabad town.

The first finding is that NIMZ Zaheerabad should not currently be read as a residential real-estate destination. It is an industrial and economic-infrastructure story. Phase-I contract works are visibly under way: earthmoving, new internal roads, a boundary fence line and a project board dated 2026. An industrial base already exists in the wider area — the 2017 planning report names Mahindra & Mahindra, MRF, Aurobindo Pharma, BHEL and others in the influence zone — so this is not an empty site being asked to become industrial from nothing.

What the field visit could not show is the next link in the chain. Infrastructure is visible. New employment inside NIMZ is not yet visible. Housing demand, rental demand and commercial activity follow employment, not roads, and none of them has been established by this report.

That turns the real-estate question around. It is not “which plot near NIMZ should I buy?” It is: if industrial activity does create employment here, where will those workers live, shop, access healthcare, educate their children and spend their income? That question is the foundation of GIR-002.

  1. Infrastructure
  2. Industry
  3. Jobs
  4. People
  5. Businesses
  6. Housing
  7. Commercial activity
  8. Real-estate demand
The field journey
  1. 01 Gachibowli

    Dense urban and commercial environment. The starting point: a mature Hyderabad economy.

    E
  2. 02 Patancheru

    Industrial, freight and manufacturing character. Heavy vehicles dominate the road.

    E
  3. 03 Sangareddy

    A growing mixed urban and industrial environment.

    E
  4. 04 Sadashivpet

    Highway-linked development and expanding activity along the corridor.

    E
  5. 05 Zaheerabad / NIMZ

    A large industrial land bank with infrastructure under construction, and comparatively limited habitation around the NIMZ itself.

    E
02 · How to read this report

Every source carries a code. Every finding carries a label.

The code tells you where a statement comes from. The label on each finding tells you what kind of statement it is. Neither is decoration: together they show exactly how much weight each line can bear.

E
Observed

Personally observed or photographed during the field visit.

O
Official

Government, NICDC, TGIIC, company or other official document or signage.

C
Confirmed

Supported by two or more independent sources.

L
Local intelligence

Reported by residents, workers, shopkeepers or landlords. Not used as proof.

A
Announced

An announcement, MoU or plan that has not necessarily materialised.

U
Unverified

A claim that requires verification and is excluded from conclusions.

Fact Verifiable from a named record. Without a source it does not publish as a fact.
Ground observation Seen or recorded on the ground. Anecdotal and time-bound.
Analysis Interpretation. Reasoned, not certain.
Investor consideration A question to answer before committing capital. Never a recommendation.
03 · What we saw

I don’t study maps. I go there.

Transport & infrastructure

EObserved
  • Heavy freight movement on the highway between Hyderabad and Zaheerabad
  • Flyover and elevated-structure construction with traffic diverted behind barriers
  • Road improvements along the corridor
  • New internal roads and street lighting at the NIMZ Phase-I site
  • NIMZ access roads and a long boundary fence line

Industrial activity

EObserved
  • Existing industrial establishments along the corridor
  • Manufacturing and warehousing / logistics activity
  • The Mahindra & Mahindra facility and its gate-level movement (see the Mahindra signal)
  • Active earthwork and construction inside the NIMZ Phase-I boundary

Settlement pattern

EObserved
  • Dense urbanisation at Gachibowli
  • An industrial and urban mix at Patancheru and Sangareddy
  • A developing corridor at Sadashivpet
  • Large-scale industrial development with comparatively limited surrounding habitation at NIMZ

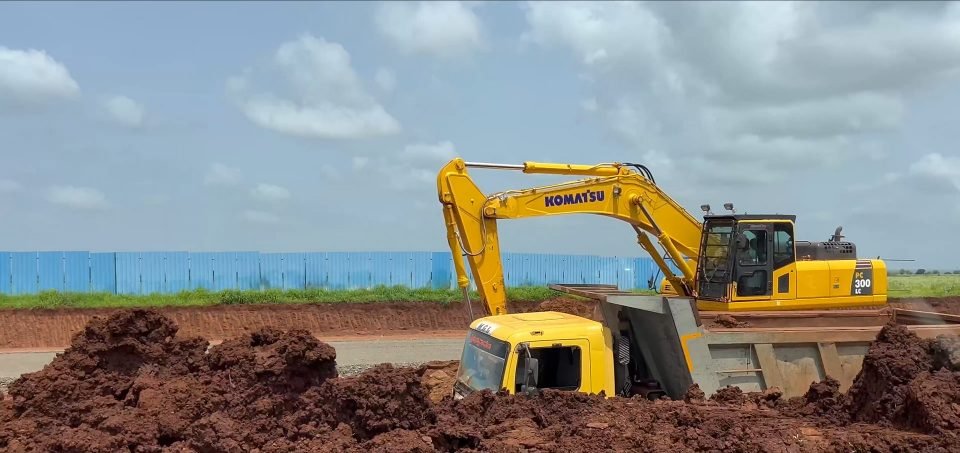

A Komatsu PC300 LC excavator loading a yellow tipper truck with red soil, in front of a long blue sheet-metal boundary fence
Evidence 01EObserved

Earthwork inside the Phase-I boundary

An excavator loading a tipper with red soil, with the blue sheet-metal boundary fence behind. Field observation recorded during GIR-001.

Shows
Heavy plant physically at work on site.
Does not show
How much of the Phase-I scope is complete, or who will occupy the land.
Sadat HM standing on a newly surfaced multi-lane road with a painted median, street-light poles and wind turbines in the distance

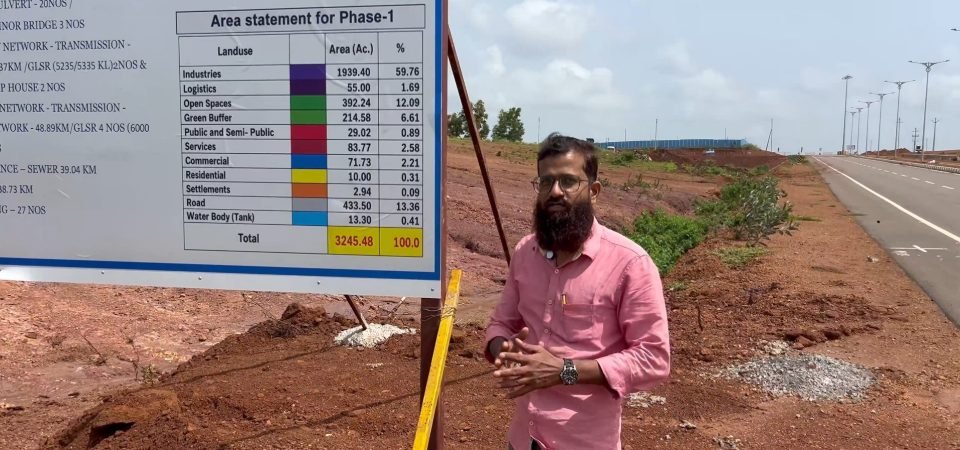

Evidence 02EObserved

A finished road, before the traffic

A newly surfaced multi-lane road with a median and street lighting near the Phase-I site. Wind turbines are visible on the skyline. Field observation recorded during GIR-001.

Shows
Completed road infrastructure with almost no traffic on it.
Does not show
Whether this road is part of the 47.82 km internal-road scope on the board, or when traffic will arrive.
A rusted, peeling NIMZ signboard of the Telangana State Industrial Infrastructure Corporation standing in green grassland, with a long fence line behind
Evidence 03EObserved

The older NIMZ, still standing

A weathered TSIIC-era NIMZ signboard in open grassland, with a newer fence line behind it. Field observation recorded during GIR-001.

Shows
The age of the NIMZ designation relative to the current works.
Does not show
Anything about current execution on its own — which is precisely why it matters.

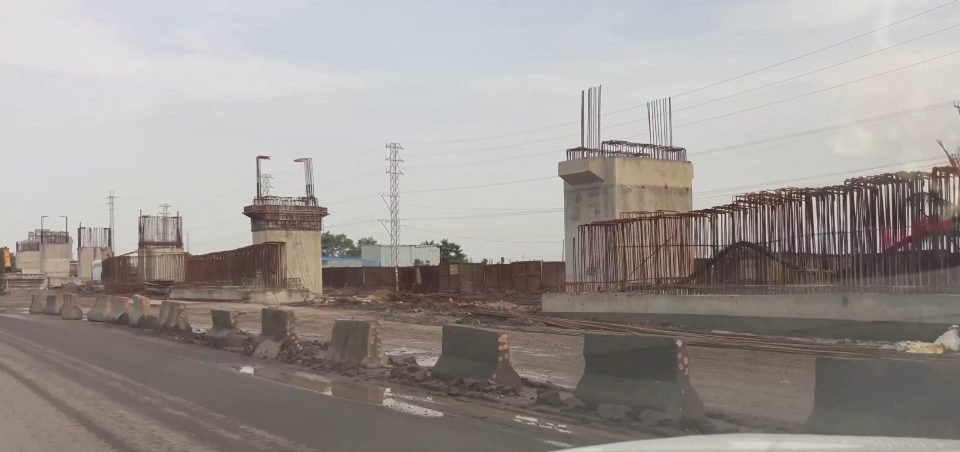

Concrete piers of an elevated highway structure with exposed reinforcement bars, behind concrete barriers beside an active road
Evidence 04EObserved

The access corridor is itself under construction

Elevated-structure piers with exposed reinforcement beside a diverted carriageway on the investigation route. Field observation recorded during GIR-001.

Shows
Road-capacity investment on the route to Zaheerabad.
Does not show
The exact chainage, the project owner or its completion date.

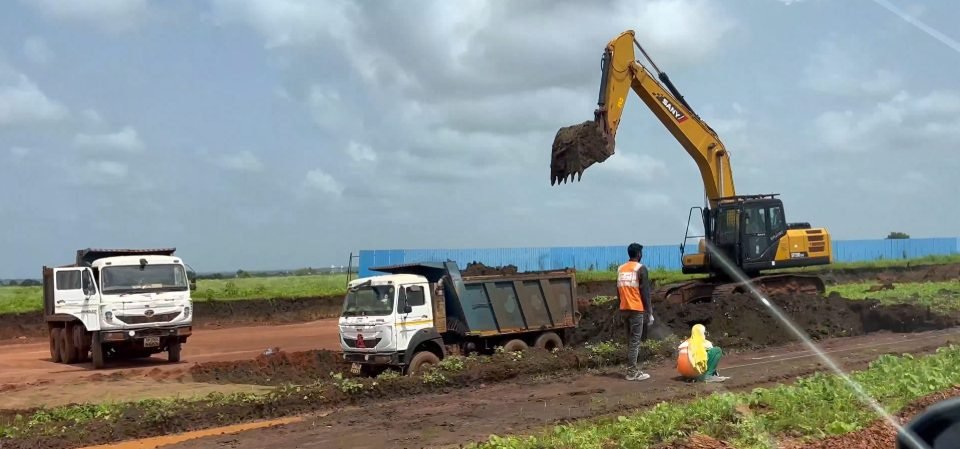

A Sany excavator lifting soil beside two white tipper trucks, with workers in safety vests and a blue boundary fence behind
Tippers and an excavator at work A second earthwork front: excavator, two tipper trucks and site staff. Field observation recorded during GIR-001. Does not show: Progress against the programme.

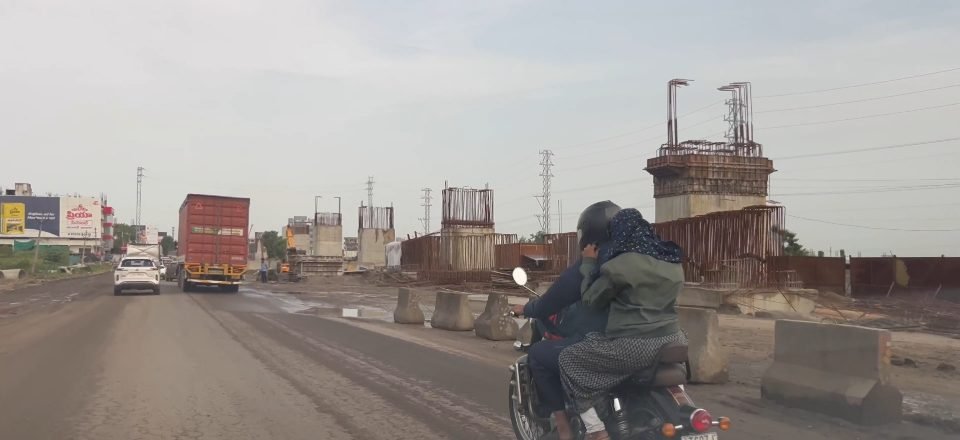

A container truck and cars travelling beside elevated-structure piers and a two-wheeler on a construction-affected highway
Freight on the corridor A container truck and mixed traffic passing highway construction. Field observation recorded during GIR-001. Does not show: Where that freight originates or ends.

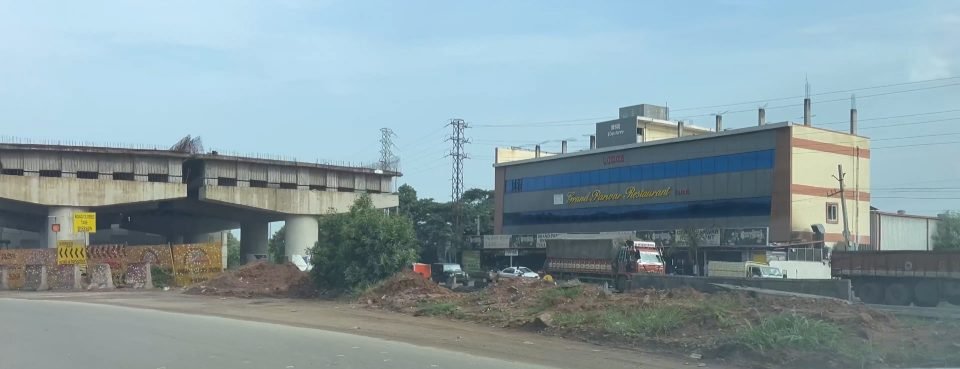

An unfinished flyover deck with a road-closed diversion sign, beside a three-storey roadside restaurant building and parked lorries
Roadside trade meeting road works An unfinished flyover beside a roadside restaurant and parked lorries on the investigation route. Field observation recorded during GIR-001. Does not show: The trading performance of those businesses.

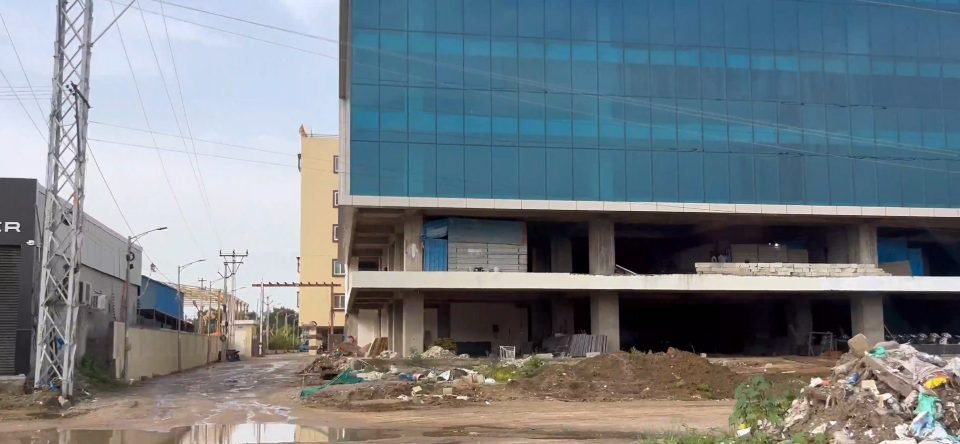

A multi-storey glass-fronted building under construction with an exposed lower floor, beside a wet service road and a power tower
New building along the route A multi-storey glazed building under construction beside a service road on the investigation route. Field observation recorded during GIR-001. Does not show: Its intended use, occupier or exact location on the route.
04 · NIMZ: what the project represents

A 2017 plan and a 2026 contract are not the same project.

The 12,635-acre conceptual NIMZ plan (2017 PFR) should not be confused with the current Phase-I activation area — 3,245.48 acres on the photographed site board, 3,245 acres on the NICDC project page. The first is a planning envelope from 2017. The second is the part now under contract.

2017 · Historical planning envelopeOOfficial
Plan area
12,635 acres (5,113 ha), Nyalkal and Jharasangam mandals — 2017 PFR, Dec 2017
Proposer
TSIIC, through SPV “Zaheerabad NIMZ Limited”
Approvals
DIPP in-principle January 2013; final approval December 2015
Concept
“Work, Live and Learn”: manufacturing, logistics, housing, amenities, utilities
Internal roads
Primary 60 m right-of-way; secondary 45 m and 30 m
Location
~80 km north-west of Hyderabad; ~10 km north of Zaheerabad; ~65 km to the ORR
Projections
~2.44 lakh direct and indirect jobs; ₹37,740 crore investment at ultimate phase — projections, 2017 PFR, Dec 2017

Source: L&T Infrastructure Engineering, Pre-Feasibility Report for TSIIC, December 2017. A planning document. It is not evidence of current execution, and its employment and investment figures are projections.

2024–2026 · Current Phase-I activationOOfficial
Programme
Zaheerabad Industrial Node, Hyderabad–Nagpur Industrial Corridor (NICDC)
Node area
12,635 acres across 17 villages — NICDC project page, accessed Sep 2026
Phase-I area
3,245.48 acres — photographed site board, 9 Aug 2026 · 3,245 acres — NICDC project page, accessed Sep 2026 · see reconciliation note
Phase-I cost
₹2,361 crore — NICDC project page, accessed Sep 2026
Location
9 km north of Zaheerabad; 80 km from Hyderabad; close to NH-65
Potential
Investment potential ₹10,000 crore; employment potential 1,74,000 jobs — targets, not outcomes; NICDC project page, accessed Sep 2026; PIB, 26 Feb 2026
Delivery
EPC agreement 06-02-2026; completion target 06-02-2029 — photographed site board, 9 Aug 2026

Sources: NICDC project page for Zaheerabad, Telangana; PIB, “Travelling Across the Industrial Corridors of India”, 26 February 2026; Phase-I site board photographed during GIR-001. “Potential” figures are official targets, not outcomes.

Land use · who the zone is being built for

Industry first. Housing, barely.

Phase-I area statement · site boardEObserved
Land useArea (acres)%
Industries 1,939.40 59.76
Logistics 55.00 1.69
Open spaces 392.24 12.09
Green buffer 214.58 6.61
Public and semi-public 29.02 0.89
Services 83.77 2.58
Commercial 71.73 2.21
Residential 10.00 0.31
Settlements 2.94 0.09
Road 433.50 13.36
Water body (tank) 13.30 0.41
Total3,245.48100.0

Photographed on the NICDIT Zaheerabad Industrial Smart City board during GIR-001. The eleven rows sum exactly to the board’s stated total.

Full NIMZ land use · 2017 planOOfficial
Land useArea (acres)%
Manufacturing 7,107 56.25
Technical infrastructure 550 4.35
Amenities and utilities 883 6.99
Housing 638 5.05
Logistics 899 7.12
Green areas 1,603 12.69
Roads 955 7.56
Total12,635100.0

2017 Pre-Feasibility Report, proposed land-use table. Percentages calculated by Sadat.in from the report’s acreages.

Analysis

The two tables describe different areas and cannot be compared line by line. What they show together is direction: the 2017 plan reserved 638 acres of the full envelope for housing, while the Phase-I board reserves 10. Phase-I is being built as a workplace. If housing arrives inside NIMZ, it belongs to a later phase or to the land outside it.

The NICDIT Zaheerabad Industrial Smart City project information board listing the work, employer, consultants, contractor, dates, cost, sixteen salient features, a colour-coded site plan and the Phase-I area statement

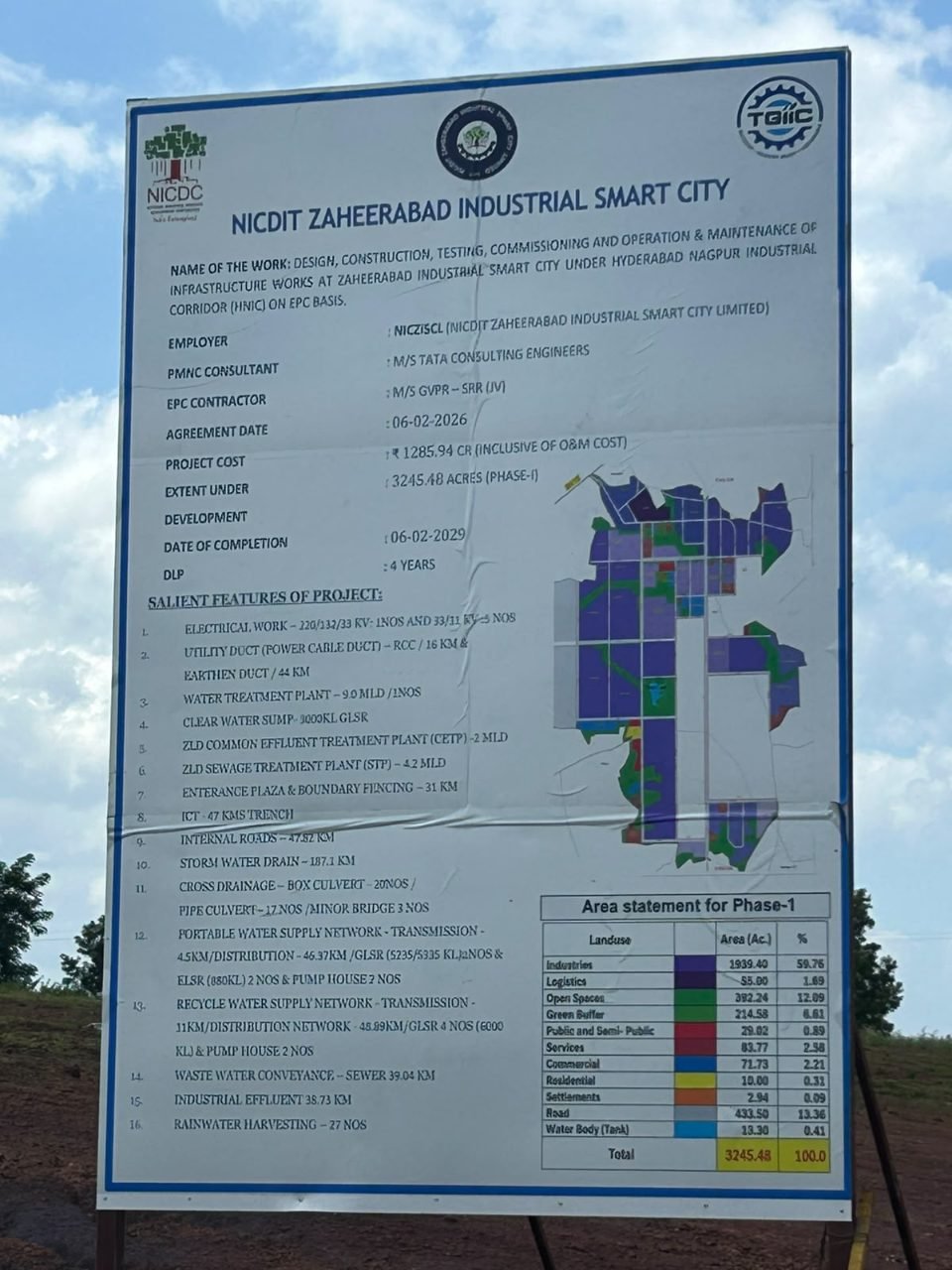

NICDIT Zaheerabad Industrial Smart City project board, carrying NICDC and TGIIC marks. Field observation recorded during GIR-001.
The Phase-I board, transcribedEObservedOOfficial

What the project says about itself, on site.

Work
Design, construction, testing, commissioning and O&M of infrastructure works at Zaheerabad Industrial Smart City under the Hyderabad–Nagpur Industrial Corridor (HNIC), EPC basis
Employer
NICZISCL — NICDIT Zaheerabad Industrial Smart City Limited
PMNC consultant
M/s Tata Consulting Engineers
EPC contractor
M/s GVPR–SRR (JV)
Agreement date
06-02-2026
Project cost
₹1,285.94 crore (inclusive of O&M cost)
Extent
3,245.48 acres (Phase-I)
Date of completion
06-02-2029
Defect liability
4 years
Sixteen salient features listed on the board
  1. Electrical: 220/132/33 kV substation (1) and 33/11 kV substations
  2. Utility duct: RCC 16 km and earthen 44 km
  3. Water treatment plant: 9.0 MLD
  4. Clear-water sump: 3,000 KL GLSR
  5. Zero-liquid-discharge CETP: 2 MLD
  6. Zero-liquid-discharge STP: 4.2 MLD
  7. Entrance plaza and boundary fencing: 31 km
  8. ICT trench: 47 km
  9. Internal roads: 47.82 km
  10. Storm-water drains: 187.1 km
  11. Cross drainage: 20 box culverts, 17 pipe culverts, 3 minor bridges
  12. Potable water: 4.5 km transmission, 46.37 km distribution, 2 GLSRs, 2 ELSRs, 2 pump houses
  13. Recycled water: 11 km transmission, 48.89 km distribution, 4 GLSRs, 2 pump houses
  14. Wastewater sewer: 39.04 km
  15. Industrial effluent line: 38.73 km
  16. Rainwater harvesting: 27 structures

Transcribed from the board photograph. The 33/11 kV substation count is partly obscured on the board and is not reproduced.

05 · Existing economic baseOOfficial

Zaheerabad is not starting from zero.

Zaheerabad is not starting from zero. The 2017 planning report names well-established industries in the NIMZ influence zone. This is the base the Phase-I platform is being added to.

  • Mahindra & Mahindra (tractor manufacturing plant)
  • MRF Tyres
  • Aurobindo Pharma
  • Sparsh Pharma
  • Cauvery Iron and Steel
  • BHEL
  • Ordnance Factory Medak
  • Bharat Dynamics
  • Trident Sugars

Listed as named in the December 2017 Pre-Feasibility Report. GIR-001 observed the Mahindra facility directly. The current operating scale of the other establishments was not verified in this investigation.

The thesis is therefore not that an empty location will suddenly become industrial. It is that an existing industrial ecosystem may receive a much larger planned industrial-infrastructure platform.

The Mahindra signalEObserved

An industrial economy, not an industrial plan.

The Mahindra & Mahindra facility is the clearest evidence in the investigation that the area already runs as an industrial economy rather than an industrial plan. The field visit recorded separate gates serving separate functions.

Gate 3
Worker and employee movement
E
Gate 2
Manufactured tractor movement
E
Gate 4
Raw material and transport movement
E
Analysis

A facility that separates people, finished goods and inbound materials has a working employment, production and logistics system. That is the pattern NIMZ is designed to repeat at scale. It is also the pattern that creates daily demand for housing, food, transport and services somewhere nearby.

Gate functions were observed by the investigator on the 9 August 2026 field visit. No photograph of the Mahindra facility is included in this edition.

Announcement record · secondary sourcesAAnnounced

What has been announced, and how the numbers moved.

Company announcements attached to NIMZ are an important signal and a poor substitute for evidence. They are recorded here because they shape how land near NIMZ is marketed — and because the figures attached to them have changed over time.

DateSourceAs reportedCode
December 2021Namasthe Telangana (Sangareddy edition)Triton Electric: 150 acres; proposed investment of ₹2,100 crore; EV manufacturing proposed; reported potential employment of 25,000A
UndatedSocial-media post (author not shown in the copy reviewed)MoU announced between Triton EV and the Government of Telangana for a proposed ₹2,100 crore EV unit at NIMZA
UndatedEenadu (Hyderabad edition), German investors’ summitLight Automotive (German company): 100 acres; proposed investment of ₹1,500 crore; automotive-component manufacturing proposedA
April 2026Deccan ChronicleHyundai R&D centre on 675 acres at ₹8,528 crore; Triton over ₹3,500 crore; VEM over ₹2,200 crore; nearly 9,000 acres reported as acquiredA
Analysis

Between the 2021 coverage and the April 2026 report, the proposed investment attached to Triton rises from ₹2,100 crore to over ₹3,500 crore. The change is not explained in the coverage reviewed. GIR-001 did not observe any of these units operating. None of these figures is used to infer actual employment, production or real-estate demand, and none is used in this report’s conclusions.

Newspaper clippings are cited, not reproduced. Telugu-language figures were checked by the investigator against the original clippings; wording is paraphrased. All figures are proposed or reported, not achieved.

06 · The infrastructure signal

What the research found

4 findings
FINDING 01

Phase-I is moving from plan to physical works.

Ground observation

Excavators and tipper trucks were working on red soil inside a long blue sheet-metal boundary fence, on at least two separate work fronts.

Source GIR-001 field record. Photographs “Earthwork inside the Phase-I boundary” and “Tippers and an excavator at work”.

Ground observation

A newly surfaced multi-lane road with a painted median and street lighting was in place near the project board, carrying almost no traffic.

Source GIR-001 field record. Photograph “A finished road, before the traffic”.

Fact

The site board records an EPC agreement dated 06-02-2026, a completion date of 06-02-2029, a contract value of ₹1,285.94 crore including O&M, M/s GVPR–SRR (JV) as contractor and M/s Tata Consulting Engineers as PMNC consultant.

Source Phase-I project board, photographed during GIR-001.

Analysis

The site is in the delivery stage of a contract let in February 2026. That is a genuine change from a designation that dates to 2013. It is still infrastructure: the board lists roads, drains, water, power and effluent systems, not factories.

Investor consideration

A completion date is a contractual target, not an outcome. When you read this, ask what share of the 47.82 km of internal roads and the utility networks is actually complete.

FINDING 02

Two eras of NIMZ are visible side by side.

Ground observation

A rusted TSIIC-era NIMZ signboard stands in open grassland with a newer fence line behind it, a short distance from works carrying 2026 dates.

Source GIR-001 field record. Photograph “The older NIMZ, still standing”.

Fact

NIMZ Zaheerabad received DIPP in-principle approval in January 2013 and final approval in December 2015.

Source L&T Infrastructure Engineering, Pre-Feasibility Report for TSIIC, December 2017, section 3.

Analysis

Roughly thirteen years separate the first approval from the EPC agreement. For most of that time the NIMZ name existed without comparable physical works. Land has been marketed on that name throughout.

Investor consideration

When land is sold on the strength of “NIMZ”, ask which NIMZ the claim refers to: the 2013 designation, the 12,635-acre plan, or the 3,245-acre Phase-I now under contract.

FINDING 03

Phase-I is allocated to industry, not housing.

Verification pending
Fact

The Phase-I area statement allocates 1,939.40 acres (59.76%) to industries and 10.00 acres (0.31%) to residential use, out of 3,245.48 acres.

Source Phase-I project board, photographed during GIR-001. Area corroborated by the NICDC project page (3,245 acres).

Fact

The 2017 plan allocated 638 acres to housing across the full 12,635-acre envelope.

Source 2017 Pre-Feasibility Report, proposed land-use table.

Analysis

Demand from Phase-I will arrive first as employers, then as workers needing rented accommodation, and only later — if at all — as owner-occupier housing. That sequence favours worker rental and services in existing towns before it favours residential products beside NIMZ.

Investor consideration

If you are offered a residential product described as “near NIMZ”, ask who the exit buyer is when the adjoining zone reserves 0.31% of its area for housing.

FINDING 04

The route to Zaheerabad is itself under construction.

Ground observation

Elevated-structure piers with exposed reinforcement, diverted carriageways behind concrete barriers, and container freight were recorded on the investigation route between Hyderabad and Zaheerabad.

Source GIR-001 field record. Photographs “The access corridor is itself under construction”, “Freight on the corridor” and “Roadside trade meeting road works”.

Analysis

Road-capacity investment on the access corridor supports the industrial case over the long term. In the short term it adds friction to every trip, including the commute any future NIMZ workforce would make.

Investor consideration

The specific highway project, its owner and its completion date were not identified in this edition. Treat corridor access as improving, not as complete.

07 · The investment logic

Where the evidence currently stops.

Real-estate demand is downstream of economic and human activity. GIR-001 traced how far along this chain the evidence currently reaches.

  1. Stage 1 Infrastructure Roads and industrial infrastructure Observed Observed. Phase-I works under way.
  2. Stage 2 Industry Factories, manufacturing and logistics Partly observed Existing industry in the influence zone. New NIMZ units not observed.
  3. Stage 3 Employment Workers, engineers, managers and suppliers Not established Not established for NIMZ.
  4. Stage 4 Population People who need somewhere to live Not established Not established.
  5. Stage 5 Consumption Food, retail, healthcare, education and services Not established Not established.
  6. Stage 6 Commercial development Shops, offices, rentals, hotels and services Not established Not established.
  7. Stage 7 Real estate Residential, commercial and land demand Not established Not established. No conclusion made.

The evidence currently reaches the first stage and part of the second. Everything after that is the subject of further investigation, not of this report.

The critical question

The first field visit did not attempt to answer “which plot should I buy?” It raised a more important question: where will the economic activity created by NIMZ actually translate into human activity?

Current working hypothesis

Zaheerabad’s opportunity may ultimately depend less on residential development immediately surrounding NIMZ, and more on the town’s ability to function as the human, rental, commercial and service ecosystem supporting industrial expansion.

Deliberately treated as a hypothesis, not a conclusion. It requires ground verification.

08 · What GIR-001 established
  1. E1
    An existing industrial base

    Zaheerabad and its influence zone already contain significant industrial activity, including a functioning Mahindra & Mahindra facility.

    EO
  2. E2
    A large integrated industrial plan

    NIMZ was planned in 2017 as a 12,635-acre integrated industrial ecosystem (2017 PFR). Phase-I is now being activated under NICDC: 3,245 acres on the NICDC page, 3,245.48 acres on the photographed site board.

    OC
  3. E3
    Visible physical infrastructure

    The field visit recorded roads, earthwork, fencing and infrastructure works around the NIMZ, under an EPC contract dated February 2026.

    EO
  4. E4
    A corridor that changes character

    The route moves from Hyderabad’s mature urban economy through industrial towns to comparatively less-developed areas around Zaheerabad.

    E
What GIR-001 did not establish
  • Guaranteed property appreciation
  • Guaranteed rental growth
  • Exact future residential demand
  • Exact NIMZ employment numbers
  • The exact number of future residents
  • Exact land-price appreciation
  • The absorption rate of plotted developments
  • That every property near NIMZ will benefit
  • That NIMZ will become a residential township
  • That any announced company is operating on site

Each requires separate verification.

09 · Investment questions remaining
  1. Where will NIMZ workers live?
  2. Where do existing industrial workers live today?
  3. What is the actual rental demand in Zaheerabad?
  4. Where do industrial workers spend their income?
  5. Are workers choosing Zaheerabad because schools are already available?
  6. Is Zaheerabad already a healthcare centre for surrounding villages and industries?
  7. Are industrial employees contributing materially to local retail demand?
  8. Is new housing actually being absorbed?
  9. Which locations show genuine transactions rather than advertised prices?
  10. Which infrastructure projects are committed, under construction, proposed or only discussed?
The most important unanswered question

Does Zaheerabad have the human ecosystem capable of absorbing the industrial growth that NIMZ is designed to create?

GIR-002 directionIn preparation. Not yet published.
  1. Industry
  2. Workers
  3. Housing
  4. Commercial activity
  5. Real estate
Zone A
Existing industrial areas
Zone B
Mahindra and major employment clusters
Zone C
Ancillary and supplier industries
Zone D
Zaheerabad town
Zone E
NIMZ perimeter and surrounding villages

To identify where economic activity is actually translating into human demand.

Risk register

What could weaken the thesis

Nothing withheld
01HIGH

Employment may lag infrastructure by years

Phase-I builds serviced land. Factories, and the jobs that create housing demand, depend on separate investment decisions by companies. No NIMZ employment was observed in GIR-001.

02HIGH

Announcements are not occupancy

The investment figures attached to named companies have changed between 2021 and 2026 coverage. Until units are built and staffed, they remain announcements.

03HIGH

Unresolved official figures

The photographed site board states 3,245.48 acres and the NICDC page 3,245 acres; August 2024 approval coverage and a January 2026 report cited in the research notes state 3,909 acres. Until reconciled, any claim that depends on the exact Phase-I boundary should be treated with caution.

04MEDIUM

Housing is not in the Phase-I plan

The Phase-I area statement allocates 0.31% to residential use. Residential demand, if it comes, will be met largely outside the zone — and not necessarily next to it.

05MEDIUM

Title and land-marketing risk

Peri-urban land marketed on the NIMZ name carries elevated title, conversion and approval risk. Nothing in this report substitutes for a legal search by an advocate you appoint.

06MEDIUM

Timelines are contractual, not guaranteed

The board’s February 2029 completion date is a target. Infrastructure programmes of this scale are frequently extended.

10 · Preliminary conclusion

Worth investigating. Not yet an investment conclusion.

Zaheerabad is worth investigating — not because someone is selling land there, but because an existing industrial ecosystem is being reinforced by a large, now physically active, planned industrial-infrastructure project.

The real investment question is what happens after the factories and infrastructure:

  1. Jobs
  2. Workers
  3. Housing
  4. Rental demand
  5. Retail
  6. Healthcare
  7. Education
  8. Commercial activity
  9. Urban expansion
  10. Real-estate demand

The purpose of the next ground investigation is to determine whether that chain is already visible in Zaheerabad town.

Report status
Field investigation
Completed
Desk research
Completed for this edition; continuing
Core thesis
Established as a working hypothesis
Phase-I area
Open — 3,245.48 / 3,245 acres vs 3,909 acres unreconciled
Real-estate conclusion
Not made
Next investigation
GIR-002: workers, town, ancillary industry and NIMZ influence zone
11 · Methodology, scope and sources
  1. 01
    Drive the corridor

    Gachibowli → Patancheru → Sangareddy → Sadashivpet → Zaheerabad / NIMZ, recording what exists rather than what is marketed.

  2. 02
    Record on site

    Video and photographs of works, signage and settlement. The Phase-I board was photographed and transcribed as displayed.

  3. 03
    Read the plan

    The 2017 Pre-Feasibility Report for the planning envelope, approvals history, land use and projections.

  4. 04
    Check the current record

    NICDC and PIB material for the current Phase-I. Where they disagree with each other or with the board, the disagreement is published.

  5. 05
    Separate announcements

    Media and company announcements are logged as A and excluded from conclusions until independently confirmed on the ground.

  6. 06
    Label every statement

    Each finding is labelled fact, observation, analysis or investor consideration, and each source is coded E, O, C, L, A or U.

Scope

This report consolidates the GIR-001 field observations and the NIMZ source material reviewed. The 2017 Pre-Feasibility Report is a historical planning source and is not, by itself, evidence of current execution.

Official “potential” and “projected” figures are reproduced as targets. None is presented as employment or investment that has occurred.

Observations from later field work — including local statements about residential prices and Zaheerabad’s role as a service hub — are intentionally excluded from this edition and will appear in GIR-002.

Photographs are original field evidence. Newspaper and social-media material is cited as secondary and is not reproduced.

Nothing in this report is investment advice, a valuation or a recommendation to buy or sell any property.

SourceTypeDate
Phase-I project board, NICDIT Zaheerabad Industrial Smart City (NICZISCL)E · Field photograph2026
GIR-001 field video and photographs, Hyderabad–Zaheerabad route and NIMZ siteE · Field record9 Aug 2026
NICDC — Zaheerabad, Telangana project page (nicdc.in)O · Official web pageAccessed Sep 2026
PIB — “Travelling Across the Industrial Corridors of India”O · Official publication26 Feb 2026
L&T Infrastructure Engineering — Pre-Feasibility Report: Development of NIMZ near Zaheerabad, for TSIIC (ref. C1171308 RP001 Rev.0)O · Planning documentDec 2017
NICDC DMU report citing a 3,909-acre Phase-I (not attached to this edition)U · Cited in research notesJan 2026
Union Cabinet approval coverage (The Hans India; Telangana Tribune; Deccan Chronicle)A · PressAug 2024
Tender-stage and foundation-stone coverage (The Realty Today; Telangana Tribune)A · PressAug 2025 · May 2026
Namasthe Telangana, Sangareddy edition, page 5A · Press8 Dec 2021
Eenadu, Hyderabad edition — German investors’ summit reportA · PressUndated
Social-media post announcing Triton EV MoUA · Social mediaUndated
Deccan Chronicle — “Industrial City Begins Operations At Zaheerabad After 13 Years”A · PressApr 2026
Corridors NH-65 Zaheerabad
Continue the investigation
Next report

GIR-002 · Zaheerabad town and the NIMZ influence zone

Workers, housing, rental demand and commercial activity. In preparation. Not yet published.

Method

How to evaluate a growth corridor

The four lenses behind this report, in full.

Use it

Growth corridor evaluation checklist

The seven questions, as a document you can take to a site visit.

Think it through

Everything on this platform is free. A conversation is the one thing that isn't automated.

If you have read the research and want a second opinion before committing capital, that is what a strategy session is for. Thirty minutes, no obligation, investor-focused.
